PDP VIII Implementation Plan
02/04/2024 15:00

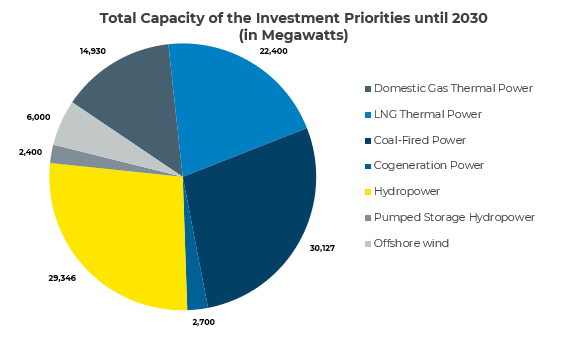

On 1 April 2024, the Prime Minister of Vietnam issued Decision 262/QD-TTg approving the plan to implement the National Electricity Development Plan for the period 2021 – 2030 (PDP8 Implementation Plan). The highly anticipated PDP8 Implementation Plan provides details of important power source projects as the industry’s investment priorities until 2030.

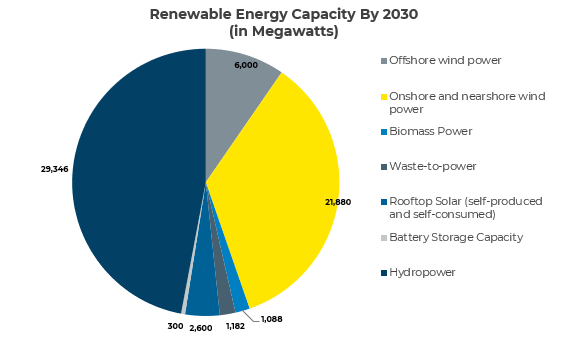

With respect to renewable energy, the total capacity to be developed by 2030 with different sources of energy and the list of power generation projects are also provided in the PDP8 Implementation Plan. The following chart provides a summary of the renewable energy capacity by 2030.
The PDP8 Implementation Plan also provides the status of the vast majority of LNG-to-Power Projects that have been approved in the PDP8 in Vietnam as follows:
No. | Projects | Capacity (MW) | Location | Expected Operation Period | Status |
1 | Nhon Trach 3 and Nhon Trach 4 LNG-to-Power | 1,624 | Dong Nai province | 2024-2025 | Under Construction |
2 | Hiep Phuoc 1 LNG-to-Power | 1,200 | Ho Chi Minh City | 2025 | Under Construction |
3 | LNG Bac Lieu | 3,200 | Bac Lieu province | 2027-2029 | Preparing Feasibility Study Report |
4 | Son My II LNG-to-Power | 2,250 | Binh Thuan province | 2027-2029 | Preparing Feasibility Study Report |
5 | BOT Son My I LNG-to-Power | 2,250 | Binh Thuan province | 2027-2029 | Preparing Feasibility Study Report |
6 | LNG Quang Ninh | 1,500 | Quang Ninh province | 2028-2029 | Preparing Feasibility Study Report |
7 | LNG Hai Lang (Phase 1) | 1,500 | Quang Tri province | 2028-2029 | Preparing Feasibility Study Report |
8 | LNG Thai Binh | 1,500 | Thai Binh province | 2029 | Investor Selection |
9 | LNG Nghi Son | 1,500 | Thanh Hoa province | 2029-2030 | Investor Selection |
10 | LNG Ca Na | 1,500 | Ninh Thuan province | 2029-2030 | Investor Selection |
11 | LNG Quang Trach II | 1,500 | Quang Binh province | 2029-2030 | No information on status available1 |
12 | LNG Quynh Lap | 1,500 | Nghe An province | 2029-2030 | No information on status available2 |
13 | LNG Long An I | 1,500 | Long An province | 2029-2030 | Preparing Feasibility Study Report |
| Potential locations for backing-up delayed or non-implemented projects |
|
| Thai Binh, Nam Dinh, Nghi Son, Quynh Lap, Vung Ang, Chan May, Mui Ke Ga, Hiep Phuoc 2, Tan Phuoc, Ben Tre, Ca Mau, etc. |
With respect to domestic gas thermal power projects, the PDP8 Implementation Plan provides details of such projects as follows:
No. | Project | Capacity (MW) | Location | Operation Year | Note |
1 | O Mon I Thermal Power Plant* | 660 | Can Tho | In operation | Using gas from Block B |
2 | O Mon II Thermal Power Plant | 1,050 | Can Tho | 2027 | |
3 | O Mon III Thermal Power Plant | 1,050 | Can Tho | 2030 | |
4 | O Mon IV Thermal Power Plant | 1,050 | Can Tho | 2028 | |
5 | Dung Quat I Combined Gas Turbine Power Plant | 750 | Quang Ngai | 2028 | Using gas from Ca Voi Xanh (Blue Whale) gas mines |
6 | Dung Quat II Combined Gas Turbine Power Plant | 750 | Quang Ngai | 2028 | |
7 | Dung Quat III Combined Gas Turbine Power Plant | 750 | Quang Ngai | 2028 | |
8 | Central Region I Combined Gas Turbin Power Plant | 750 | Quang Nam | 2030 | |
9 | Central Region II Combined Gas Turbin Power Plant | 750 | Quang Nam | 2030 | |
10 | Quang Tri Combined Gas Turbine Power Plant | 340 | Quang Tri | 2030 | Using gas from Bao Vang (Yellow Leopard) gas mines |
Notes:
- (*) Existing power plants switch to using gas from Block B.
- The exact scale of the power plants will be determined in accordance with the capacity of the unit in the project implementation phase.
With respect to offshore wind projects, the PDP8 Implementation Plan does not provide any specific details on any on-going projects but provide the details of increased power capacity of the localities/regions as follows:
No. | Region | Increased Capacity during 2023-2030 (MW) |
1 | Northern Vietnam | 2,500 |
2 | North Central Vietnam | 0 |
3 | Central Vietnam | 500 |
4 | Highlands | 0 |
5 | South Central Vietnam | 2,000 |
6 | Southern Vietnam | 1,000 |
| Total Increased Capacity | 6,000 |
With respect to waste-to-energy projects, the PDP8 Implementation Plan also provides a summary of the current status of various waste-to-energy projects.
No. | Projects | Capacity (MW) | Operation Year | Note |
Bac Ninh province | 36.7 |
| ||
1 | Investment Project to Build an Industrial Waste and Domestic Solids Treatment Complex | 6.1 |
| In operation |
2 | Investment Project to Build a High-Tech Domestic Solid Waste Treatment Plant That Generates Energy | 11.6 |
| In operation |
3 | Investment Project to Build a High-Tech Domestic Solid Waste Treatment Plant That Generates Energy | 13 |
| In operation |
4 | Project Of Domestic Solid Waste Treatment Area Focusing on Electricity Generation | 6 |
| In operation |
| Lang Son province | 11 |
| |
1 | Waste-To-Energy Power Plant Lang Son | 11 | 2026-2030 | |
| Nam Dinh province | 15 |
| |
1 | Greenity Nam Dinh Waste-To-Energy Power Plant | 15 | 2023-2025 | Under construction |
| Hai Phong city | 40 |
| |
1 | Domestic Solid Waste Treatment Plant Using Waste Incineration Technology To Generate Electricity | 20 | 2026-2030 | At Tran Duong town |
2 | Dinh Vu (Phase 1) Domestic Solid Waste Treatment Plant Using Waste Incineration Technology To Generate Electricity | 20 | 2026-2030 | |
| Thanh Hoa province | 18 |
| |
1 | Domestic Waste-To-Energy Thanh Hoa | 18 | 2026-2030 | |
| Ha Tinh province | 30 |
| |
1 | Waste treatment and power generation plant | 30 | 2026-2030 | Hong Loc town, Loc Ha district, Ha Tinh province |
| Phu Yen province | 15 |
| |
1 | Trung An waste treatment and power generation plant | 15 | 2026-2030 | |
| Binh Phuoc province | 15 |
| |
1 | Tan Hung Hon Quan waste-to-energy plant | 15 | 2026-2030 | |
| Dong Nai province | 66 |
| |
1 | Vinh Tan (Phase 1) waste-to-energy plant | 20 | 2026-2030 | |
2 | Quanh Trung waste-to-energy plant | 7.5 | 2026-2030 | |
3 | W2E Dong Nai (Phase 1) waste-to-energy plant | 20 | 2026-2030 | |
4 | Dinh Quan (Phase 1) waste-to-energy plant | 18.5 | 2026-2030 | |
| Ba Ria – Vung Tau province | 30 |
| |
1 | Ba Ria – Vung Tau waste-to-power plant | 5 | 2026-2030 | |
2 | Toc Tien 02 waste-to-power plant | 20 | 2026-2030 | |
3 | Toc Tien waste-to-power plant | 5 | 2026-2030 | |
| Soc Trang province | 16 |
| |
1 | Solid waste-to-energy plant | 16 |
| |
| Ben Tre province | 15 |
| |
1 | Solid waste-to-energy plant | 15 | 2026-2030 | |
| Tien Giang province | 10 |
| |
1 | Tien Giang waste-to-energy plant | 10 | 2026-2030 | |
| Vinh Long province | 14 |
| |
1 | Waste-to-energy plant | 14 | 2026-2030 | |
| Kien Giang province | 14 |
| |
1 | Hon Dat waste-to-energy plant | 10 | 2026-2030 | |
2 | Phu Quoc waste-to-energy plant | 4 | 2026-2030 | |
| Ca Mau province |
|
| |
1 | Ca Mau waste-to-energy plant | 4 | 2026-2030 | |
2 | Nam Can waste-to-energy plant | 6 | 2026-2030 | |
3 | U Minh waste-to-energy plant | 6 | 2026-2030 |
For further information on details on the projects above, please feel free to reach out if you have any questions.
Click here to download: Frasers Legal Update - PDP VIII Implementation Plan - April 2024
[1] The PDP8 Implementation Plan does not provide the status update of this project.
[2] The PDP8 Implementation Plan does not provide the status update of this project.
